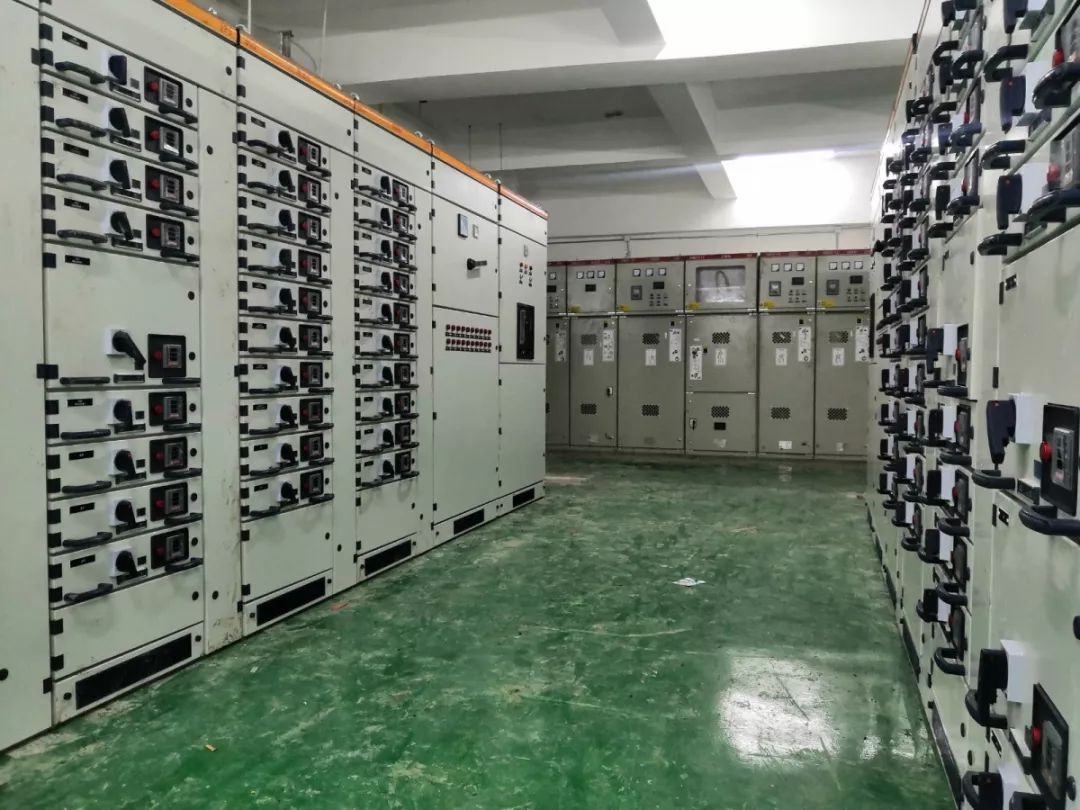

12月(yue)26日上午,達昌府項目開(kai)關站,總、分專變供配電設(she)(she)備已全部(bu)進(jin)場,接下來(lai)進(jin)行供配電設(she)(she)備的安裝工(gong)作。達(da)(da)昌(chang)府(fu)(fu)供電(dian)工(gong)(gong)(gong)程開(kai)工(gong)(gong)(gong)以(yi)來,達(da)(da)昌(chang)府(fu)(fu)項(xiang)目部(bu)積極協調,全力(li)推進(jin)小區供配電(dian)工(gong)(gong)(gong)程建設(she)工(gong)(gong)(gong)作(zuo)(zuo)。截至(zhi)目前(qian)(qian),達(da)(da)昌(chang)府(fu)(fu)項(xiang)目電(dian)力(li)排管,開(kai)關站至(zhi)總、分專變電(dian)纜橋架已全部(bu)完(wan)成,目前(qian)(qian)正在(zai)進(jin)行(xing)井道內母線的安裝(zhuang)工(gong)(gong)(gong)作(zuo)(zuo)。為(wei)(wei)加快施工(gong)(gong)(gong)進(jin)度,搶(qiang)抓(zhua)送電(dian)時間,達(da)(da)昌(chang)府(fu)(fu)項(xiang)目部(bu)正在(zai)推進(jin)配電(dian)間土建工(gong)(gong)(gong)作(zuo)(zuo),協調安裝(zhuang)公司同(tong)步安排配電(dian)間設(she)備進(jin)場(chang)安裝(zhuang),為(wei)(wei)后續穿設(she)線纜工(gong)(gong)(gong)作(zuo)(zuo)創造(zao)條件。
另外,嘉(jia)匯(hui)商業中心項目專(zhuan)變供(gong)配電設備已全部(bu)安裝完(wan)成,電力(li)排管(guan),電纜橋架也已全部(bu)完(wan)成。
下一步,達(da)昌府(fu)項目部和嘉匯(hui)商業中(zhong)心項目部將與施工單(dan)位緊密配合(he),盡快、盡好地(di)完(wan)成設備安裝、調試,確保項目年(nian)前送電。
